All insights

DCFR Insight 31 / Data Center Delivery + Quality Control

Design Review + Owner-Side Architecture

Owner-Side Data Center Design Reviews at 30%, 60%, 90%, and IFC

A data center design package should not advance because the drawings look more complete. It should advance only when the decisions appropriate to that milestone are resolved, coordinated, measurable, and safe to release downstream.

Owner-Side Data Center Design Reviews at 30%, 60%, 90%, and IFC

Design Maturity Is Decision Maturity

A 30% design review and a 90% design review should not ask the same questions. At 30%, the owner should prevent the team from developing the wrong building. At 60%, prevent disciplines from developing incompatible systems. At 90%, prevent the contractor from receiving ambiguous, incomplete, or unbuildable documents. At Issued-for-Construction, know exactly which uncertainties remain, who owns them, and whether they can affect procurement, permitting, construction, energization, commissioning, or operations. For an owner-side architect, design review is not redrawing the Architect or Engineer of Record's work. It verifies that architecture, engineering, vendor information, owner requirements, authority conditions, construction logic, maintenance strategy, and operational intent converge into one executable facility.

DESIGN MATURITY IS NOT THE PERCENTAGE OF DRAWINGS COMPLETED. IT IS THE PERCENTAGE OF CRITICAL DECISIONS THAT HAVE BEEN RESOLVED, COORDINATED, AND MADE SAFE TO RELEASE DOWNSTREAM.

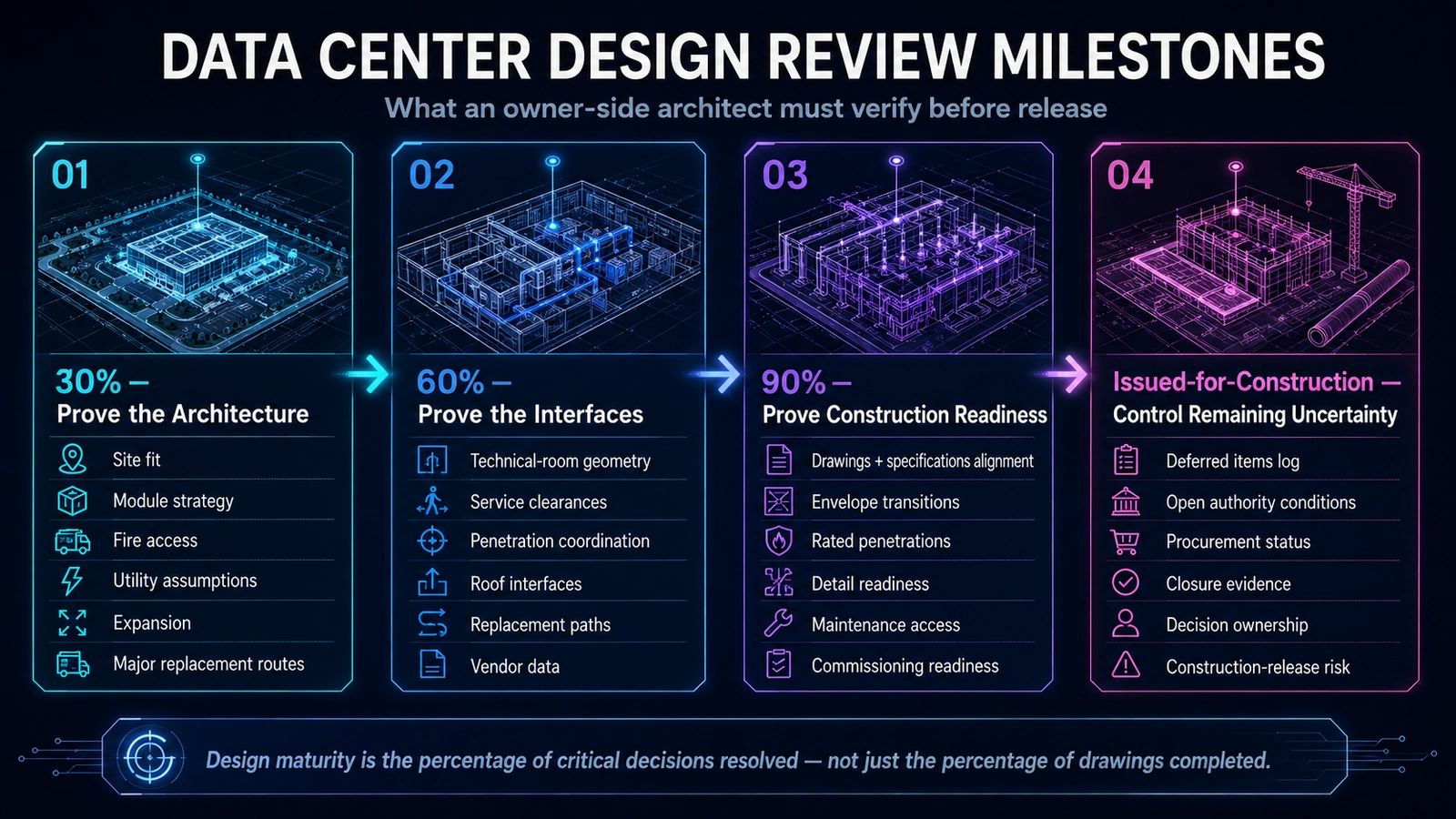

Four owner-side data center design-review milestones from 30 percent through construction release.
30%, 60%, 90%, and Issued-for-Construction are not simply drawing-completion percentages. Each milestone should prove a different level of design maturity before downstream work is released.

Start With the Owner's Review Basis

Owner review comments need a governing basis. An owner-side review should not become: “This is how I would have designed it.” Every significant comment should trace to a requirement, risk, interface, owner objective, or unresolved decision. The owner-side architect checks physical translation and coordination without casually assuming the responsible professional's engineering duty.

Owner Review Basis

Review BasisWhat It ControlsOwner-Side Question
Owner's Project Requirements (OPR)Capacity, resilience, operations, security, maintainabilityDoes this design still deliver what the owner bought?
Basis of Design (BOD)Technical design intent and assumptionsDoes the package follow the approved design basis?
Reference DesignRepeatable portfolio solutionHas the site adapted the reference correctly?
Adopted CodeRegulatory minimum requirementsHas the responsible design professional demonstrated compliance?
Authority Having Jurisdiction (AHJ)Project-specific interpretationAre unresolved authority conditions visible and owned?
Manufacturer RequirementsEquipment geometry, installation, operationDoes the building accommodate actual selected equipment?
Engineer of Record (EOR)Discipline-specific professional designAre engineering requirements translated into physical space and interfaces?
Insurer / Factory Mutual (FM)Property-loss-prevention criteria where applicableAre insurer-driven requirements incorporated?
CommissioningFunctional verificationCan the completed system actually be tested?
OperationsMaintainability and continuityCan equipment be operated, isolated, serviced, and replaced?

Use Five Technical-Basis Labels

Labels show where a requirement comes from and who confirms it. The National Fire Protection Association (NFPA) publishes the National Electrical Code (NEC) and fire-protection standards; applicability and adopted editions require project-specific confirmation. Do not write “Corridor too narrow.” Identify the route use, controlling basis, required clear dimension, and responsible confirming party. Where information is unknown, mark PROJECT-SPECIFIC CONFIRMATION REQUIRED.

Technical-Basis Labels

ClassificationMeaning
CODE / REGULATORYRequired by adopted regulation.
ENGINEERINGDetermined by responsible design engineer.
MANUFACTUREREquipment-specific installation, service, or replacement requirement.
OWNER STANDARDPortfolio or project requirement established by owner.
DCFR PLANNING ALLOWANCEEarly planning assumption pending final design information.
PROJECT-SPECIFIC CONFIRMATION REQUIREDJurisdiction, equipment, or project information remains to be confirmed.

30% Review — Prove the Architecture

At approximately 30%, prove site fit, capacity, building module, major yards, access, utilities, expansion, fire strategy, security, stormwater, and replacement strategy. Do not spend most owner-review effort on minor room tags, finish notes, decorative elevations, or small drafting issues. Geometry is still movable; review high-cost decisions first.

30% Site Fit

Review the physical chain: parcel → buildable envelope → data center building → electrical yard → generator yard → cooling yard → loading → parking → stormwater → security → fire access → utilities → expansion.

  1. 1

    Does target Information Technology (IT) capacity physically fit

    Does target Information Technology (IT) capacity physically fit?

  2. 2

    Is the data hall module strategy visible

    Is the data hall module strategy visible?

  3. 3

    Is future expansion protected

    Is future expansion protected?

  4. 4

    Is the utility edge understood

    Is the utility edge understood?

  5. 5

    Can major trucks enter and leave

    Can major trucks enter and leave?

  6. 6

    Is a credible loading and equipment-delivery strategy shown

    Is a credible loading and equipment-delivery strategy shown?

  7. 7

    Is stormwater consuming realistic land

    Is stormwater consuming realistic land?

  8. 8

    Are generators and cooling equipment positioned with sensitive neighbors in mind

    Are generators and cooling equipment positioned with sensitive neighbors in mind?

  9. 9

    Can major equipment eventually be replaced

    Can major equipment eventually be replaced?

  10. 10

    Does security conflict with emergency access

    Does security conflict with emergency access?

  11. 11

    Can construction staging occur

    Can construction staging occur?

  12. 12

    Are major site assumptions explicitly identified

    Are major site assumptions explicitly identified?

Dimension Fire Access at 30%

CODE / REGULATORY — As a current model-code reference basis, 2024 International Fire Code (IFC) Section 503.2.1 establishes a 20'-0" minimum unobstructed fire apparatus access-road width and 13'-6" minimum unobstructed vertical clearance. This is a 2024 International Fire Code reference basis; verify the edition, amendments, fire-code official requirements, and project-specific conditions adopted by the jurisdiction. A plan should not merely show a red line labeled “FIRE ACCESS.” The preliminary route should carry real planning dimensions and identify their source. The infographic is explanatory: depicted dimensions may represent a code reference, local setback, DCFR PLANNING ALLOWANCE, or project-specific assumption and are not all universal code requirements.

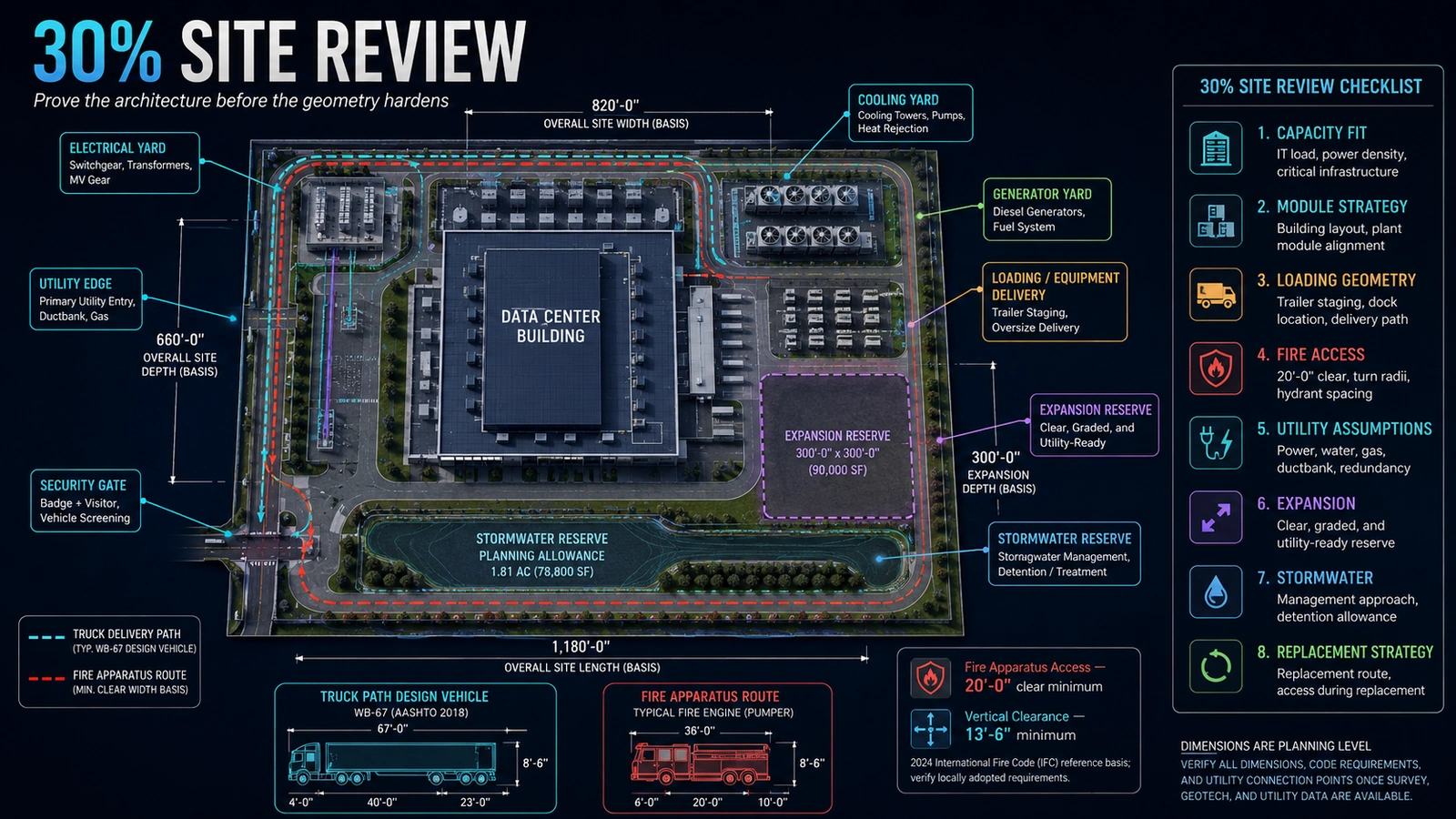

Owner-side 30 percent data center site design review diagram.
At 30%, test the architecture and site strategy while major geometry can still move: capacity, infrastructure yards, fire access, utilities, expansion, logistics, stormwater, and major replacement paths.

Prove the Building Module at 30%

After defining megawatt (MW), a box labeled “40 MW Data Center” is insufficient. OWNER STANDARD / DCFR PLANNING ALLOWANCE — an illustrative 40 megawatt Information Technology load may become 4 × 10 megawatt data hall modules rather than one vague room. These are planning examples, not universal requirements. Identify target IT load, rack-density and rack-count bases, module capacity and quantity, support-space organization, electrical and mechanical spine, and phasing. These decisions affect structure, electrical distribution, cooling, commissioning, construction sequence, and future operation.

30% Owner-Side Release Gate

If several critical items remain open, producing more drawings does not make the project more mature. It makes redesign more expensive.

30% Owner-Side Release Gate

Release ItemStatus
Target IT capacity reconciled with buildingPASS / OPEN
Data hall module strategyPASS / OPEN
Major technical roomsPASS / OPEN
Electrical yardPASS / OPEN
Generator yardPASS / OPEN
Cooling / heat rejectionPASS / OPEN
Truck / loading geometryPASS / OPEN
Fire apparatus accessPASS / OPEN
Security zoningPASS / OPEN
Stormwater reservePASS / OPEN
ExpansionPASS / OPEN
Major equipment replacementPASS / OPEN
Utility assumptionsCONFIRMED / OPEN
Major authority issuesCLOSED / OPEN
Reference-design deviationsAPPROVED / OPEN

60% Review — Prove the Interfaces

At 60%, ask: CAN ALL OF THESE SYSTEMS PHYSICALLY COEXIST? Review switchgear ↔ room geometry; battery system ↔ fire protection ↔ ventilation; mechanical piping ↔ rated wall; busway ↔ structure; cable tray ↔ sprinkler; roof curb ↔ structure ↔ roofing; louver ↔ façade ↔ acoustics; transformer ↔ utility ↔ fire exposure; security gate ↔ fire route; and cooling equipment ↔ service clearance ↔ acoustic screen. Serious failures often happen between disciplines, not within one drawing set.

Technical Rooms — Stop Drawing Equipment as Rectangles

Each major item needs separate envelopes. These dimensions are not interchangeable. A room may fit installed equipment and still be impossible to maintain or replace.

  1. 1

    1 — Equipment footprint

    Actual installed equipment.

  2. 2

    2 — Code / regulatory clearance

    Only where applicable.

  3. 3

    3 — Engineering working space

    Established by the responsible design engineer and applicable requirements.

  4. 4

    4 — Manufacturer service clearance

    Doors, panels, filters, coils, breakers, pumps, and batteries.

  5. 5

    5 — Component withdrawal

    The largest removable component.

  6. 6

    6 — Full-equipment replacement

    Space and route for removing the complete equipment.

Final service, working, withdrawal, and replacement dimensions must come from applicable code, the responsible engineer, actual selected equipment, and approved manufacturer documentation. Infographic dimensions are illustrative, not universal technical requirements.

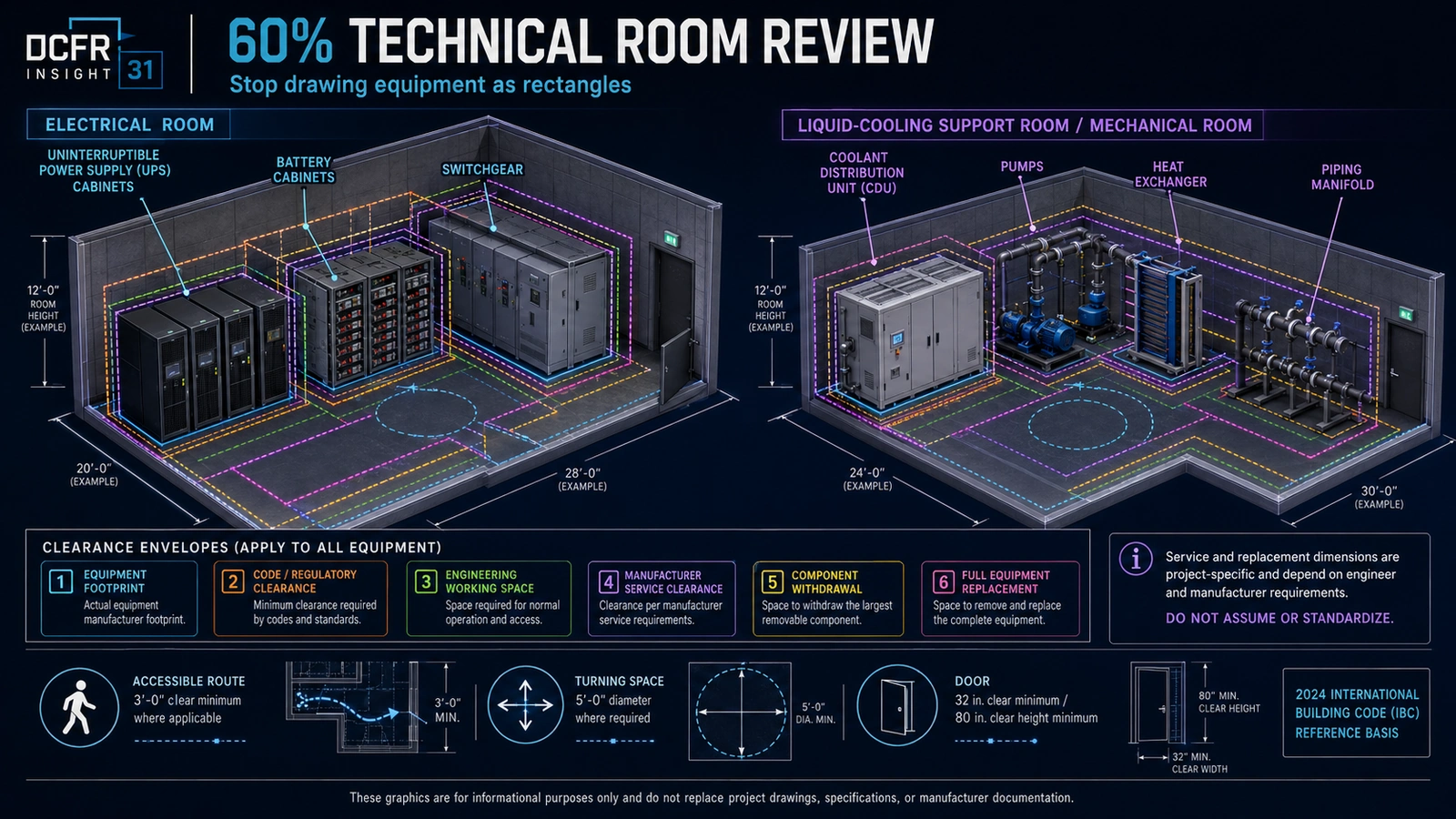

Owner-side 60 percent technical-room equipment-envelope review diagram.
At 60%, equipment should no longer appear as simple rectangles. Review equipment footprint, regulatory and engineering clearances, manufacturer service space, component withdrawal, and full-equipment replacement as separate envelopes.

Doors — Code Compliance vs Equipment Replacement

CODE / REGULATORY — Under the 2024 International Building Code (IBC) Section 1010.1.1 reference basis, applicable means-of-egress doors generally require a 32-inch minimum clear opening width and 80-inch minimum clear opening height. Verify the adopted edition, local amendments, occupancy conditions, and applicable exceptions. A 32-inch clear egress width does not equal an adequate equipment replacement opening. MANUFACTURER / ENGINEERING / PROJECT-SPECIFIC CONFIRMATION REQUIRED — verify shipping width and height, disassembly, rigging, turning geometry, adjacent equipment, removable panels, and floor loading for Uninterruptible Power Supply (UPS) equipment, switchgear, battery cabinets, Coolant Distribution Units (CDUs), pumps, heat exchangers, and transformers.

Accessibility — Apply It Correctly

CODE / REGULATORY — Where an accessible route is required, the Americans with Disabilities Act (ADA) Accessibility Standards generally use a 36-inch minimum clear walking surface, with limited conditions permitting shorter 32-inch clear segments. Confirm applicability and project conditions. Do not imply every technical equipment aisle is an accessible route. Distinguish accessible circulation, employee work area, equipment access, electrical working space, manufacturer service clearance, egress, and replacement path. Avoid both under-dimensioning and blind use of one dimension everywhere.

At 60%, Review the Roof Like a Technical Floor Plan

A roof with every unit fitting in plan can still fail operationally if equipment cannot be serviced, replaced, or reroofed around.

Roof Interface Review

Roof InterfaceOwner-Side Check
Equipment curbsLocation, size, structural support
Roof penetrationsQuantity, grouping, waterproofing
Primary drainageCoordination with equipment and structure
Overflow drainageUnobstructed
WalkwaysMaintenance route
ScreensWind / structure / acoustics
ExhaustSeparation / re-entrainment
Louvers / intakesAirflow / weather
Lightning protectionEquipment coordination
Fall protectionMaintenance safety
ReplacementCrane / rigging access
Future equipmentReserved zones

At 60%, Review Penetration Strategy

Ask whether every assembly maintains water, air, thermal, vapor, fire-resistance, acoustic, and security control when systems pass through it. Review roof-to-wall, wall-to-foundation, rated-wall, cable-tray, busway and pipe penetrations, louvers, equipment curbs, and expansion joints.

Require an Equipment Replacement-Path Drawing

Trace public road → secured entry → internal service road → laydown → crane or forklift zone → removable panel or door → internal route → technical room → final position. Record the largest shipping section, width, height, weight, turning requirement, opening, floor loading, rigging, temporary protection, and shutdown consequence. MANUFACTURER / ENGINEERING / PROJECT-SPECIFIC CONFIRMATION REQUIRED.

A FACILITY DESIGNED TO OPERATE FOR DECADES SHOULD NOT REQUIRE MAJOR DEMOLITION EVERY TIME A CRITICAL ASSET REACHES END OF LIFE.

60% Owner-Side Release Gate

Release only when technical-room geometry, service envelopes, replacement paths, openings, penetrations, rated walls, roof, structure, distribution, security, vendor data, and procurement dependencies are coordinated or explicitly logged.

60% Owner-Side Release Gate

Review ItemRequired Status
Technical-room dimensionsCoordinated
Equipment service envelopesShown
Major replacement pathsDemonstrated
Door/opening sizesVerified
Major penetrationsCoordinated
Rated wallsCoordinated with systems
Roof curbsLocated
DrainageCoordinated
LouversSized / located
Structural openingsCoordinated
Equipment padsCoordinated
Cable / tray / busway zonesCoordinated
Mechanical distributionCoordinated
Fire-protection interfacesCoordinated
Security interfacesCoordinated
Vendor informationIncorporated or logged
Major procurement dependenciesIdentified

90% Review — Read It Like a Contractor

If this package were bid and built tomorrow, what would become a Request for Information, submittal exception, change order, field conflict, water-intrusion problem, commissioning failure, maintenance problem, or operational-shutdown risk? This review should be forensic.

Review Drawings and Specifications Together

Cross-check wall type ↔ specification; roof assembly ↔ roofing specification; door rating ↔ schedule ↔ hardware; firestop ↔ penetration detail ↔ specification; sealant ↔ joint detail; insulation ↔ performance criteria; louver ↔ performance specification; equipment pad ↔ structural requirement; finish ↔ room use; and access panel ↔ maintainable component. The contractor should not discover contradictions first.

90% Envelope Review — Focus on Transitions

Review roof-to-wall, wall-to-foundation, parapet, door threshold, louver perimeter, pipe and cable penetrations, equipment curbs, expansion joints, and screen attachments. Trace WATER CONTROL, AIR CONTROL, THERMAL CONTROL, VAPOR CONTROL, and FIRE RESISTANCE continuously through every interface.

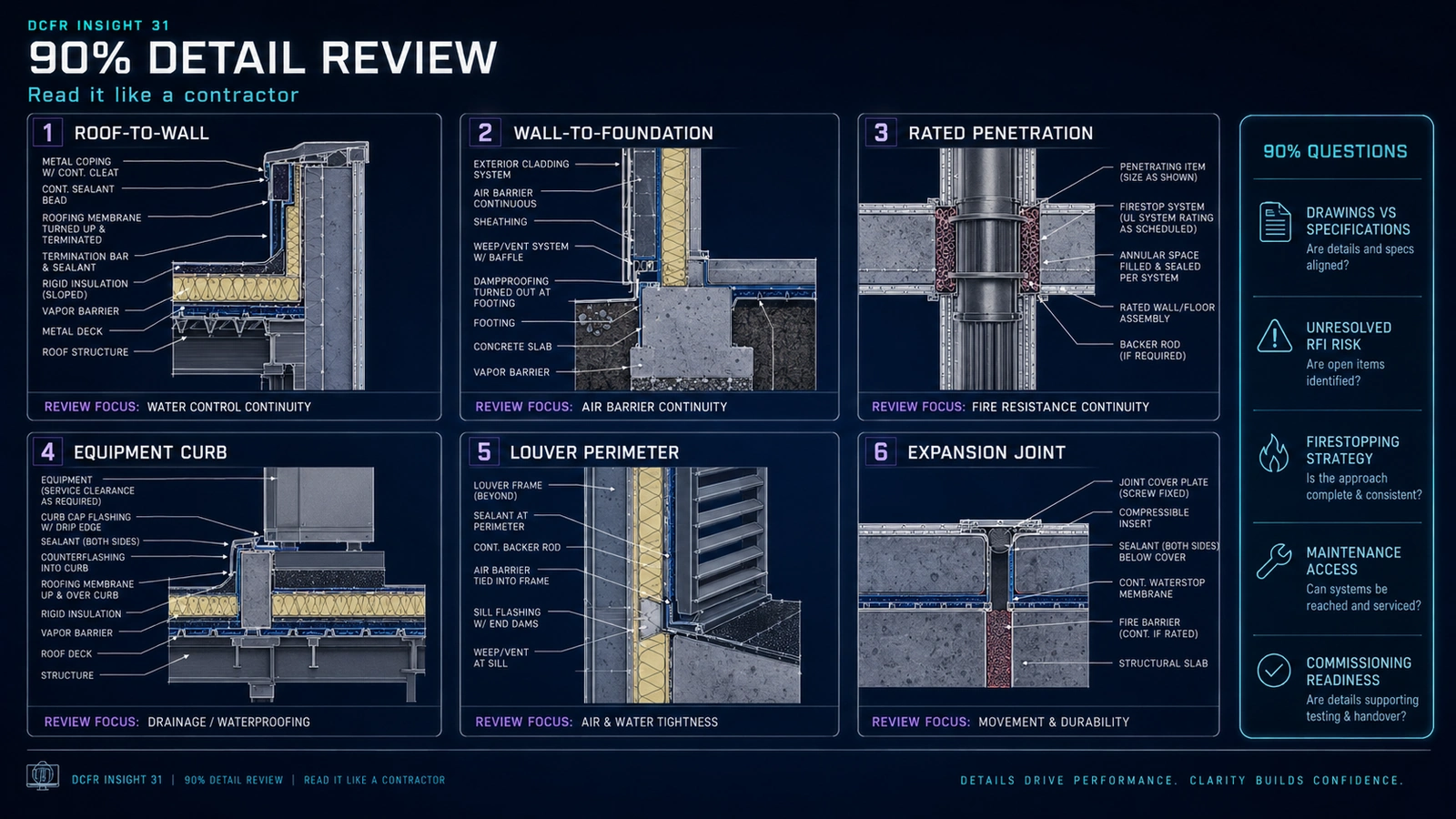

Owner-side 90 percent architectural interface and detail review diagram.
At 90%, review the transitions most likely to fail in construction or operation: roof-to-wall, wall-to-foundation, rated penetrations, equipment curbs, louvers, screens, and expansion joints.

Firestopping Is a System — Not a Generic Note

Do not accept “Firestop all penetrations” as complete coordination. Understand the rated assembly, penetrating item and size, opening, annular space, tested/listed firestop system, backing or packing, inspection, and identification. Selection and approval of the actual tested/listed system is project-specific and requires responsible design, firestop, and inspection coordination.

Review Maintenance Above Ceilings and Behind Equipment

Can each valve, filter, breaker, panel, actuator, detector, leak sensor, fire damper, pump seal, and removable pipe section be accessed and serviced? Can one redundant system be maintained while the other remains available? Building Information Modeling (BIM) clash detection is not enough. “Zero clashes” does not prove operational maintainability.

Long-Lead Decisions Must Be Visible

Design and procurement milestones do not always coincide. Critical packages include transformers, switchgear, generators, UPS equipment, batteries, chillers, CDUs, air-handling equipment, modular electrical and mechanical skids, and façade systems. Lead times are market-, manufacturer-, configuration-, project-, and date-specific; require current quotations and schedules. Need-on-site date ← transport and installation ← factory testing ← manufacturing ← approved submittal ← purchase order ← design release ← owner decision.

Procurement Dependency Register

Make every design decision, vendor-data dependency, required release, and late impact visible. Required release dates are PROJECT-SPECIFIC CONFIRMATION REQUIRED.

Procurement Dependency Register

PackageDesign Decision RequiredVendor Data NeededRequired ReleaseDesign Impact if Late
TransformerRating / configurationDimensions, weight, connectionsProject-specificYard / structure / utility
SwitchgearTopologyLineup dimensionsProject-specificRoom / openings / busway
GeneratorUnit / modelDimensions, weight, exhaustProject-specificYard / acoustics / fuel
UPSArchitectureCabinet geometryProject-specificRoom / battery / access
BatteryChemistry / configurationCabinet / rack dataProject-specificFire / mechanical / room
CDUCooling architectureCapacity / connectionsProject-specificPiping / drainage / access
ChillerEquipment selectionDimensions / loadsProject-specificStructure / yard / roof

Lead times and releases require current, project-specific quotations and schedules.

90% Release Gate

Close or explicitly track code and authority comments, deviations, equipment geometry and replacement routes, rated assemblies, firestop, envelope transitions, roof and drainage, drawing/specification coordination, long-lead release bases, commissioning and maintenance access, vendor items, and owner decisions.

90% Release Gate

Review ItemRequired Status
Major code commentsClosed
Authority commentsClosed / tracked
Reference-design deviationsApproved
Major equipment dimensionsIncorporated
Equipment replacement routesVerified
Rated assembliesDetailed
Major firestop conditionsCoordinated
Envelope transitionsDetailed
Roof penetrationsCoordinated
DrainageCoordinated
SpecificationsCoordinated with drawings
Long-lead packagesRelease basis established
Commissioning accessVerified
Maintenance accessVerified
Open vendor itemsExplicitly logged
Owner decisionsClosed or escalated

Issued-for-Construction — Control Remaining Uncertainty

A construction release does not mean every unknown has disappeared. It means remaining unknowns are explicit and controlled. Register authority conditions, deferred submittals, vendor and utility dependencies, field verification, owner-furnished equipment, temporary works, mockups, preinstallation meetings, commissioning dependencies, and future phases. Each needs an owner, due date, affected construction activity, last responsible decision date, and closure evidence.

Write Better Owner Review Comments

WEAK — Move door. STRONG — EQUIPMENT REPLACEMENT: Current door location conflicts with the documented switchgear replacement route. Architect and electrical Engineer of Record (EOR) to verify largest shipping section, turning geometry, electrical working space, egress, and final route before the next issue. WEAK — Corridor too narrow. STRONG — ACCESS / MAINTAINABILITY: Confirm whether this route serves accessible circulation, routine maintenance, component withdrawal, or complete replacement. Dimension the controlling clear width and identify whether the basis is code/regulatory, engineering, manufacturer, owner standard, or planning allowance. WEAK — Coordinate with mechanical. STRONG — RATED PENETRATION: Mechanical piping crosses the rated enclosure. Architect, mechanical Engineer of Record, and fire-protection team to coordinate opening, penetrant configuration, rated-assembly continuity, and applicable tested/listed firestop system before release.

Owner Review Comment System

A useful comment moves to objective closure.

  1. 1

    1 — Identify issue

    What is the risk or conflict?

  2. 2

    2 — Identify basis

    Code/regulatory, engineering, manufacturer, owner standard, or planning allowance?

  3. 3

    3 — Identify impact

    Capacity, safety, cost, schedule, operations, or commissioning?

  4. 4

    4 — Responsible party

    Who must resolve it?

  5. 5

    5 — Required action

    What must change, be documented, or be confirmed?

  6. 6

    6 — Closure evidence

    How will resolution be verified?

  7. 7

    7 — Closed

    Issue resolved and documented.

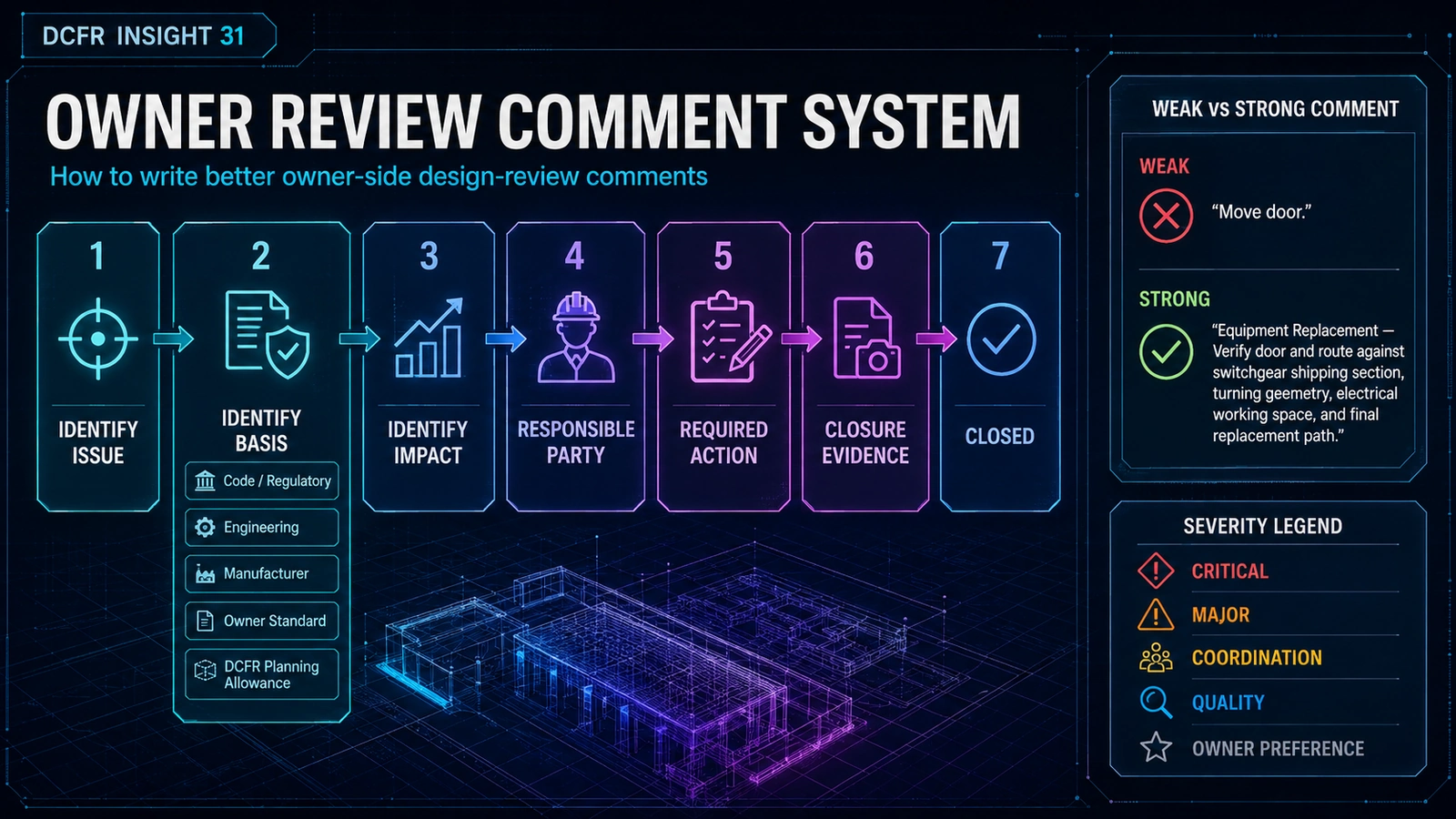

Owner-side design-review comment workflow from issue identification through closure evidence.
A high-quality owner comment identifies the issue, governing basis, consequence, responsible party, required action, and objective closure evidence.

Comment Severity

Do not let cosmetic markup volume hide critical technical risk.

Comment Severity

SeverityMeaningExample
CRITICALPrevents safe or responsible release.Life safety, insufficient capacity, unresolved utility conflict.
MAJORMaterial cost, schedule, or operational impact.Equipment replacement blocked.
COORDINATIONMultidiscipline resolution required.Pipe through rated wall.
QUALITYDocumentation incomplete.Missing detail reference.
OWNER PREFERENCEDesirable but not governing.Noncritical finish preference.

Every Comment Needs Closure Evidence

Do not close a comment because someone writes “Addressed.” Evidence may be a revised drawing/detail reference, approved vendor dimension, engineer confirmation, Authority Having Jurisdiction (AHJ) response, replacement-route drawing, owner decision, deviation record, or tested/listed system identification.

Owner-Side Design Review Dashboard

Comment count is not project risk. Five unresolved critical decisions may matter more than hundreds of drafting comments.

Owner-Side Design Review Dashboard

MetricWhy It Matters
Critical comments openRelease risk
Major comments openCost / schedule risk
Decisions overdueDesign latency
Authority issues openPermit risk
Vendor dependencies openProcurement risk
Reference-design deviations openPortfolio-control risk
Equipment clearances unverifiedConstructability / operations risk
Replacement paths unverifiedLifecycle risk
Commissioning dependencies openTurnover risk
Repeat comments from prior milestoneClosure-quality problem

The Owner-Side Review Sequence

REVIEW THE SITE BEFORE THE ROOMS. REVIEW THE ROOMS BEFORE THE DETAILS. REVIEW THE INTERFACES BEFORE THE FINISHES. REVIEW REPLACEMENT BEFORE APPEARANCE. REVIEW COMMISSIONING BEFORE CONSTRUCTION HIDES ACCESS. REVIEW UNRESOLVED DECISIONS BEFORE RELEASING MORE DOCUMENTS.

Common Owner-Side Review Failures

Each failure allows unresolved risk to migrate downstream.

  1. 1

    FAILURE 1

    Reviewing every milestone with the same checklist.

  2. 2

    FAILURE 2

    Reviewing only architectural drawings.

  3. 3

    FAILURE 3

    Assuming Building Information Modeling clash detection proves maintainability.

  4. 4

    FAILURE 4

    Reviewing equipment after room geometry has been frozen.

  5. 5

    FAILURE 5

    Tracking comments without decision ownership.

  6. 6

    FAILURE 6

    Closing comments without objective evidence.

  7. 7

    FAILURE 7

    Ignoring specifications.

  8. 8

    FAILURE 8

    Ignoring commissioning requirements.

  9. 9

    FAILURE 9

    Ignoring full-equipment replacement.

  10. 10

    FAILURE 10

    Issuing documents with hidden assumptions.

The DCFR Design Principle

30%: PROVE THE ARCHITECTURE. 60%: PROVE THE INTERFACES. 90%: PROVE CONSTRUCTION READINESS. ISSUED-FOR-CONSTRUCTION: CONTROL EVERY REMAINING UNCERTAINTY.

A DESIGN PACKAGE SHOULD ADVANCE ONLY WHEN THE DECISIONS APPROPRIATE TO THAT STAGE ARE SUFFICIENTLY RESOLVED TO MAKE THE NEXT STAGE SAFE.

Final Takeaway

For an owner-side architect, the objective is not to produce the most redlines. It is to identify the few unresolved decisions and interfaces that materially affect capacity, permitting, procurement, construction, commissioning, maintainability, replacement, cost, schedule, and operational continuity—and force them to closure before they migrate downstream.

30%, 60%, AND 90% SHOULD NOT DESCRIBE HOW MUCH HAS BEEN DRAWN. THEY SHOULD DESCRIBE HOW MUCH CRITICAL DESIGN RISK HAS BEEN RESOLVED.

Current Technical Basis — August 2026

International Code Council

2024 International Building Code

Model-code reference basis; verify adopted edition, amendments, occupancy conditions, and exceptions.

International Code Council

2024 International Fire Code

Model-code reference basis; verify adopted edition, amendments, fire-code official requirements, and project conditions.

United States Access Board

Americans with Disabilities Act Accessibility Standards

Verify scope, applicable route conditions, and project-specific requirements.

National Fire Protection Association (NFPA)

National Electrical Code

Verify the adopted edition and engineering application for the project.

National Fire Protection Association

Codes and Standards

Identify and verify project-applicable fire-protection standards with responsible professionals and authorities.

Project-specific equipment manufacturers

Approved Product Installation, Service, and Replacement Documentation

Actual equipment clearances, shipping sections, service envelopes, and replacement requirements must come from approved selected-equipment documentation.

Technical basis reviewed August 2026. Cooling technology, equipment capability, vendor qualification, and industry guidance continue to evolve; project decisions should use the latest applicable manufacturer data and professional engineering analysis.

Capacity-delivery review checklist

What to verify before the next release gate.

  • Review the site before rooms, rooms before details, and interfaces before finishes.
  • Verify capacity, service envelopes, full-equipment replacement, authority conditions, procurement dependencies, and commissioning access.
  • Assign every unresolved decision an owner, deadline, downstream impact, and objective closure evidence.

What DCFR would flag

Delivery risks that should be visible early.

DCFR would flag target capacity unreconciled with geometry; missing equipment data; undimensioned fire access; absent service or replacement envelopes; personnel egress treated as equipment replacement; unproven replacement routes; unresolved rated penetrations; generic roof or envelope transitions; drawing/specification conflicts; hidden vendor dependencies; open authority issues; procurement dependent on undecided design; missing commissioning access; or critical comments repeatedly carried forward.

Professional confirmation required

Items requiring project-specific validation.

PROJECT-SPECIFIC CONFIRMATION REQUIRED for adopted codes and amendments, authority interpretations, insurer criteria, local setbacks, actual equipment geometry and clearances, engineering working space, accessibility scope, tested/listed firestop systems, procurement lead times, vendor release dates, commissioning requirements, and every early planning allowance.

Final takeaway

30%, 60%, AND 90% SHOULD NOT DESCRIBE HOW MUCH HAS BEEN DRAWN. THEY SHOULD DESCRIBE HOW MUCH CRITICAL DESIGN RISK HAS BEEN RESOLVED.

Surface site, code, utility, and delivery risk before it becomes expensive.

DCFR converts early assumptions into planning-grade flags, confirmation registers, and decision-ready feasibility outputs.
